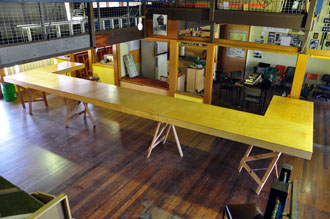

October 17 base boards assembled
|
October 17 Sub road
bed cut |

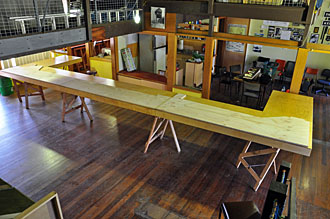

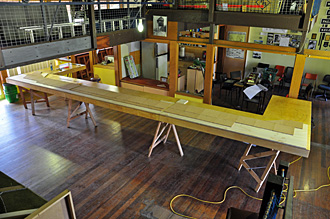

October 24 subroadbed
fixed and cork cut |
|
|
|
December 19 track laying

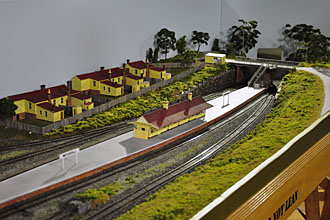

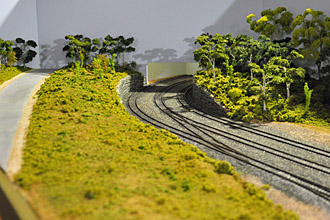

Sydney end, station and structures |

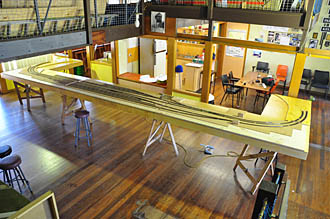

January 14 track
laying front boards
complete
|
staging yard

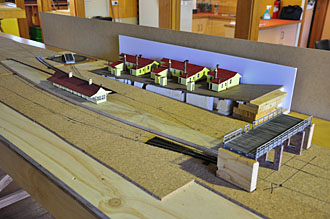

boards completed and
test fitted February 7
|
|
|
|

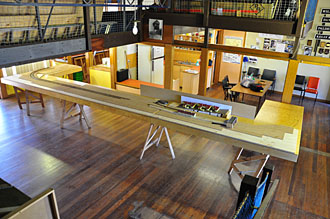

December

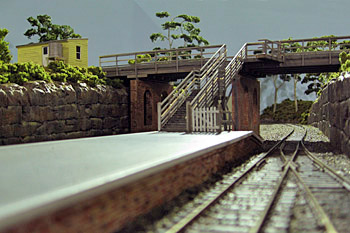

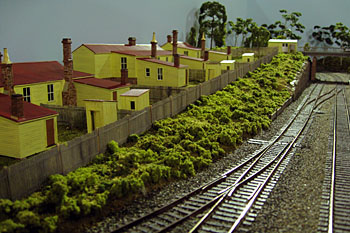

19 Station, platfrom, bridge, turntable, workers cottages
|

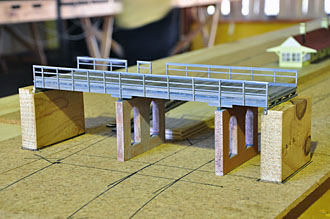

December 19 Bridge test fitting
|

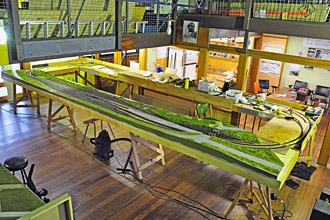

July 9 Bridge test fitting
|
|
|
|
July 11 old fiddle yard
fiited up,

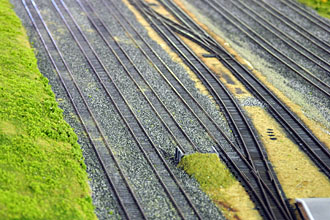

ballasting in progress
|

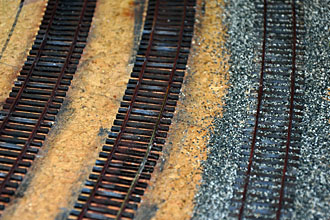

July 11 ballasting
in progress |
July 11 ballasting
in progress
|
|
|
|

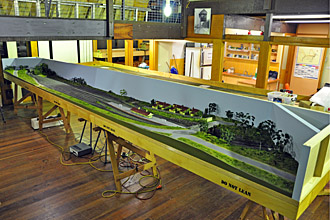

July 16 ballasting completed, trees
painted,
buildings and
backscenes fitted
|
July 16
|
July 16 |
|
|
|
25
July
|
25
July
|
25
July weighbridge
|
|
|
|
|
|
|
21 May
|
21 May |
21 May |
26 June which blue for the backscene ?
|
Group decision making
|
Sleeper painting
|
|
|
|
26
June
|
26
June |
2
July
26
June |
|
|
|
6 July rewiring a DC
controller plug
|
6 July Making sure the point motors go in
the correct direction
|

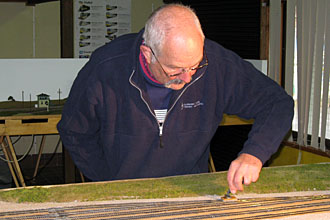

6 July cleaning paint off the tracks
|
|
|
|

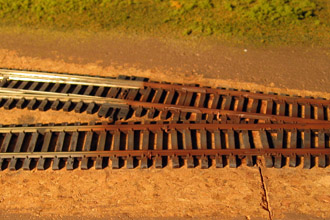

7 July spray painting the track
|
|
7 July spray painting the track |
|
|
|
15 July cleaning paint off the
tracks
Auscision trees
|
16 July planting trees
|
fitting the BLUE backscenes
|
